New Connection of MEPCO Meter: Obtaining a new MEPCO electricity meter no longer demands tedious visits or prolonged paperwork. The entire procedure has been streamlined into an accessible digital pathway, allowing applicants to lodge their requests online and observe progress without unnecessary friction.

This guide unfolds a clear, sequential explanation of the official method for securing a new MEPCO connection, breaking down each stage so applicants can proceed with confidence rather than guesswork. From initial submission to status monitoring, every step is designed to be navigable and time-efficient.

New Connection of MEPCO Meter

For individuals who already possess an active MEPCO connection and simply wish to review their most recent charges, the option to access the MEPCO BILL ONLINE remains readily available, offering immediate insight without delay.

حالیہ پالیسی تبدیلی کے مطابق اب Net Metering کو تبدیل کرکے Net Billing کر دیا گیا ہے۔
یہ فیصلہ سولر صارفین، خاص طور پر نئے صارفین، کے لیے بڑی مالی تبدیلی لے کر آیا ہے۔
🔹 کیا تبدیل ہوا؟
✅ 1) سسٹم میں بنیادی تبدیلی
پہلے نیٹ میٹرنگ میں درآمد (Import) اور برآمد (Export) یونٹس ایڈجسٹ ہو جاتے تھے۔
اب نیٹ بلنگ میں خریدی گئی بجلی اور بیچی گئی بجلی کا حساب الگ الگ ہوگا۔
✅ 2) Existing Users کے لیے Buy Back Rate میں کمی

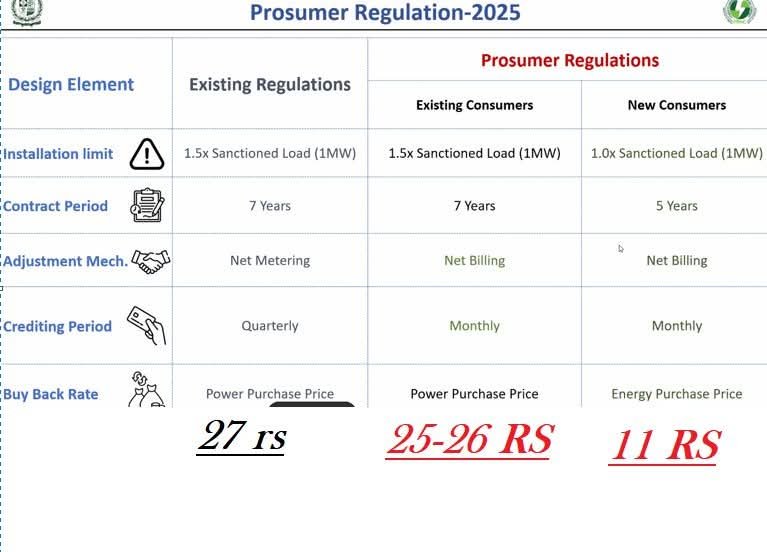

پہلے ریٹ تقریباً: Rs 27 / یونٹ
اب نیا ریٹ: تقریباً Rs 25–26 / یونٹ
✅ 3) New Users کے لیے Buy Back Rate میں بڑی کمی
نیا ریٹ: تقریباً Rs 11 / یونٹ
یعنی نئے صارف کو گرڈ کو دی گئی بجلی کا معاوضہ بہت کم ملے گا۔
✅ 4) استعمال شدہ بجلی کا بل بدستور ادا کرنا ہوگا
ہر صارف کو اپنی استعمال شدہ (Import) یونٹس کا بل دینا ہوگا،
اور یہ ریٹ عام طور پر تقریباً Rs 40 فی یونٹ یا اس سے زائد بن سکتا ہے (ٹیکسز/سرچارجز کے ساتھ مزید فرق بھی آ سکتا ہے)۔

🔹 اس کا عام صارف پر کیا اثر ہوگا؟
📌 سولر کی واپسی (Payback Period) بڑھ جائے گی
خاص طور پر نئے صارفین کے لیے سرمایہ واپس آنے میں زیادہ وقت لگ سکتا ہے۔
📌 بِل میں وہ کمی نہیں آئے گی جو پہلے آتی تھی
کیونکہ خرید اور فروخت کے ریٹس میں بڑا فرق ہو گیا ہے۔
📌 لوڈ مینجمنٹ اب زیادہ اہم ہو گئی ہے
دن کے وقت اپنی پیدا کی گئی سولر بجلی خود استعمال کرنا پہلے سے زیادہ فائدہ مند ہے۔

🔹 Existing اور New صارفین کے درمیان فرق
Existing صارفین کو نسبتاً بہتر ریٹ (25–26) ملے گا، مگر پہلے سے کم۔
New صارفین کو صرف 11 روپے کے قریب ریٹ ملنا، مالی طور پر بڑا فرق پیدا کرے گا۔

🔹 کیا کرنا چاہیے؟
✅ اپنے سسٹم کا لوڈ پروفائل چیک کریں۔
✅ دن کے وقت زیادہ سے زیادہ اپنے آلات چلائیں تاکہ self-consumption بڑھے۔
✅ بیٹری/ہائبرڈ آپشنز کا ٹیکنیکل اور مالی جائزہ لیں۔
✅ نئے سولر پلان سے پہلے مکمل ROI calculation ضرور کریں۔

New Connection Procedure

New Connection of MEPCO Meter
New Connection of MEPCO Meter

How to Apply for a New MEPCO Electricity Connection

Applying for a new MEPCO electricity connection has evolved into a digitally guided process that minimizes confusion and manual effort. By carefully following the official steps, applicants can ensure their request moves forward without unnecessary delays.

Begin by accessing the official online application form through the Apply Here option. Once the portal opens, locate the Apply button positioned on the left-hand side of your computer screen. From there, select your electricity distribution company and choose MEPCO from the list.

Next, specify your relevant subdivision, such as Multan Cantt, followed by the appropriate category type, for example 15KW, depending on your power requirements. You will then be required to enter your neighbor’s meter reference number, which helps MEPCO validate the location and grid alignment.

Afterward, select the nature of your connection—whether Domestic, Commercial, Industrial, or another applicable category. Proceed to carefully enter your personal details, ensuring accuracy in every field. You must also declare how many electricity meters are already registered under your name, as this information plays a role in eligibility assessment. New Connection of MEPCO Meter

Required Documents for New Meter Application

To finalize the online submission, certain documents must be uploaded in image format. These include a copy of the property ownership or allotment document, an attested CNIC copy of the applicant, and an attested CNIC copy of a witness. Additionally, you will need to upload a copy of a neighbor’s electricity bill along with the wiring contractor’s test report, which confirms the safety and readiness of the internal wiring. New Connection of MEPCO Meter

What Happens After Form Submission

Once the online form is successfully submitted, print all uploaded documents and organize them into a complete file. This file must then be submitted to your designated MEPCO subdivision office.

Following submission, MEPCO officials will scrutinize the application and conduct a physical site inspection to verify the provided details. If the survey outcome is satisfactory, a demand notice will be issued. This notice outlines the payable charges required to proceed. New Connection of MEPCO Meter

Print the demand notice, attach the wiring contractor’s test report, and deposit the specified fee at the designated bank. Upon confirmation of payment, the process advances toward meter installation. New Connection of MEPCO Meter

If you encounter any difficulty or require clarification at any stage of the application, you may contact MEPCO HELPLINE for official guidance and support.

MEPCO New Connection Demand Notice Fee [ March 2025 ]

Demand Notice Fee for a New MEPCO Connection

The demand notice charges for a new MEPCO electricity connection are not fixed nationwide; instead, they fluctuate based on geographical placement and development status. In simpler terms, the payable amount varies between rural and urban localities. New Connection of MEPCO Meter

For rural areas, the demand notice fee for a domestic electricity meter generally falls between PKR 10,000 and PKR 12,000. These regions typically involve lower infrastructure costs, which reflects in comparatively modest charges. New Connection of MEPCO Meter

In contrast, urban areas attract higher fees. The cost usually ranges from PKR 15,000 to PKR 25,000, with premium housing societies and densely developed neighborhoods often positioned at the upper end of this scale. The final amount is calculated in accordance with MEPCO’s prevailing tariff framework and the specific location of the property.

Because tariff schedules and area classifications may change, it is strongly recommended to visit your nearest MEPCO office to obtain the most accurate and updated information regarding the new meter demand notice fee for 2025.

How to Check New MEPCO Connection Application Status

After submitting the demand notice fee, applicants are not left in the dark. MEPCO provides a straightforward tracking mechanism that allows you to monitor your new connection’s progress using either your CNIC or the reference number mentioned on the demand notice.

To begin, navigate to the official tracking page using the Track Your Application Here option. Once the page loads, locate the Track button positioned at the top-left corner of your screen. New Connection of MEPCO Meter

You will be presented with two tracking methods. The first option allows you to check the status through your CNIC, while the second option requires a tracking ID. This tracking ID is your 14-digit reference number, as printed on the demand notice.

By entering the correct details, you can instantly view the current stage of your new MEPCO connection application.

For those who already have an active connection and wish to review billing details, you can also check your new or existing MEPCO WAPDA connection bill through the official online platform without visiting any office. New Connection of MEPCO Meter

New Connection up to date 2026

New MEPCO Connection – Updated Guidelines for 2026

As of 2026, the procedure for acquiring a new MEPCO electricity connection continues to operate under a refined and regulation-driven framework. While the core application structure remains familiar, MEPCO has emphasized tighter verification, clearer documentation standards, and improved digital tracking to reduce delays and procedural ambiguity. New Connection of MEPCO Meter

Applicants are now expected to rely primarily on the online application system, which serves as the official entry point for all new connection requests. Accuracy in data submission has become critical; even minor inconsistencies in CNIC details, property records, or wiring reports can slow the approval cycle.

The site survey phase has gained additional importance in 2026. MEPCO field officers thoroughly inspect wiring safety, load requirements, and location authenticity before clearing an application. This step ensures grid stability and prevents unauthorized or unsafe installations.

Demand notice charges remain location-sensitive, influenced by whether the property falls within a rural boundary, an urban zone, or a high-value housing society. These charges are calculated strictly under MEPCO’s latest tariff schedule, making on-ground confirmation at the subdivision office a practical necessity.

Once the demand notice fee is deposited, applicants can monitor progress digitally using their CNIC or 14-digit tracking reference number, ensuring transparency from approval to meter installation.

Overall, the 2026 MEPCO new connection process prioritizes compliance, documentation precision, and traceable workflows—favoring applicants who prepare thoroughly and follow official channels without shortcuts.

New Connection of MEPCO Meter

Estimated Time for MEPCO New Meter Installation

The processing duration for a new MEPCO electricity connection is not uniform and often stretches beyond initial expectations. The timeline largely hinges on the connection category, which MEPCO determines according to the approved load capacity. Each category follows its own verification rhythm, technical checks, and administrative clearances.

Category 1 (Up to 15 kW) – Estimated Timeframe

Category 1 connections are commonly allocated to domestic consumers and small-scale commercial setups, including residential houses, neighborhood shops, clinics, and modest office spaces. Due to the relatively lower load requirement, this category is generally processed faster than higher-capacity connections—though it is not immune to delays.

The overall process typically unfolds in phases rather than a single action. It begins with online application submission, followed by document scrutiny at the subdivision level. Once paperwork is found satisfactory, MEPCO schedules a site survey, during which technical staff verify wiring standards, load feasibility, and location authenticity.

After successful inspection, a demand notice is generated. The timeline then depends heavily on how quickly the applicant pays the prescribed fee and submits proof to the relevant office. Only after payment confirmation does the request move toward meter installation and energization.

In practical terms, Category 1 applications may progress smoothly when documentation is precise and workloads at the subdivision office are manageable. However, missing records, survey backlogs, or seasonal demand spikes can extend the waiting period.

Applicants are advised to track their application status regularly using their CNIC or tracking reference number and maintain direct coordination with their local MEPCO subdivision office to avoid unnecessary stagnation.

StepsProcedureDays
1Fill out the online application form (ENC) and attach all required documents.1 day
2Print the submitted documents, prepare a file, and submit it to the MEPCO subdivision office for approval.1 day
3Once your application is approved, the concerned officer will verify documents and schedule a site survey.4 days
4After the survey is completed, MEPCO will process your application and generate the new connection demand notice.4 days
5Once processing is done, you will receive an SMS notification stating: “Your Demand Notice 2025 is ready. Please print and pay at the bank.”1 day
6Obtain a wiring test report and attach it to the paid demand notice.1 day
7After payment, you can track your application status.20–30 days
8Issuance of the connection order.5 days
9The MEPCO storekeeper arranges your meter.10 days
10Final step: Meter installation at your premises.1 day

Total Estimated Processing Time

Overall Estimated Duration: 48 Days
Note: Actual timelines may fluctuate depending on geographical location, subdivision workload, technical inspections, and verification intensity.

Category-2 (16 kW to 70 kW / 400 Volts)

The application pathway for a Category-2 MEPCO connection closely mirrors that of Category-1, following the same digital submission, documentation review, site inspection, and demand notice issuance. However, because this category involves a higher electrical load, additional technical scrutiny and internal approvals are required.

As a result, the complete installation cycle for Category-2 connections may extend up to 68 days, starting from the date of application submission. Delays are more likely if transformer capacity assessments or load-balancing checks are necessary within the area.

Category-3 (71 kW to 500 kW / 400 Volts)

For Category-3 connections, the procedural structure remains consistent with lower categories, but the complexity increases significantly due to the substantial load demand. These applications often require multi-level technical validation, grid feasibility analysis, and senior-level authorization.

Because of these expanded requirements, the installation timeframe for a Category-3 MEPCO connection can reach up to 100 days from the initial submission date. Industrial zones, commercial plazas, and large facilities typically fall under this category, where safety compliance and infrastructure readiness are critically evaluated.

Applicants in Category-2 and Category-3 are strongly advised to maintain continuous coordination with their respective MEPCO subdivision offices and monitor their application status regularly to prevent avoidable delays.

FAQs

How can I apply for a new MEPCO electricity connection?

You can apply through MEPCO’s official online portal by completing the digital application form, selecting your category and subdivision, and uploading the required documents. After submission, a physical file must be submitted to the relevant subdivision office.

What documents are required for a new MEPCO connection?

Applicants must provide property ownership or allotment proof, attested CNIC copies of the applicant and witness, a neighbor’s electricity bill copy, and a wiring contractor’s test report. Incomplete or unclear documents may delay approval.

How long does it take to get a new MEPCO connection?

Processing time depends on the load category. Category-1 connections may take up to 48 days, Category-2 up to 68 days, and Category-3 can extend to 100 days, subject to verification, workload, and technical approvals.

How much is the demand notice fee for a new meter?

Demand notice charges vary by location. Rural areas generally incur lower fees, while urban and well-developed societies may face higher costs. The exact amount is determined under MEPCO’s official tariff structure.

How can I check the status of my new connection application?

Once the demand notice is issued or paid, you can track your application online using either your CNIC or the 14-digit tracking reference number mentioned on the demand notice.

Can I apply for more than one meter on the same CNIC?

Yes, but MEPCO requires applicants to declare the number of meters already registered under their CNIC. Approval depends on load eligibility, usage category, and compliance with regulations.

What happens if there is a delay in installation?

Delays usually occur due to incomplete documents, pending site surveys, transformer capacity issues, or heavy workload at the subdivision office. Regular follow-ups and accurate documentation help minimize delays.

Where can I get help if I face issues during the application process?

For assistance, applicants can contact the MEPCO Helpline or visit their nearest MEPCO subdivision office for official guidance and clarification.
